Skip to main content

Overview

The Scheduling → Scheduling Reports submodule provides key reporting tools for production planning, materials management, and inventory forecasting. These reports are used daily by production schedulers to manage and coordinate complex manufacturing workflows. It enables schedulers and planners to identify shortages, generate production recommendations, and project quantity-on-hand levels after scheduled runs are completed. The reports integrate with external Excel-based analysis tools and support both automated and on-demand generation. These reports help answer questions such as:
  • “What parts are needed to complete scheduled batches?”
  • “What adjustments should be made to maintain target inventory levels?”
  • “How will our inventory look once current production is finished?”
  • “Which orders require immediate production attention?”
  • “What raw materials will purchasing need for upcoming production?”

Report Options

The submodule contains the following reports:
  • Batch Net Requirements: Identifies shortages and purchasing needs for work-in-process batches.
  • Batch Ticket Recommendations: Suggests batch adjustments or new scheduling based on rolling usage data, weeks-on-hand targets, and available quantities.
  • QOH Forecast: Projects quantity-on-hand after scheduled production using 6- or 12-month rolling usage data.

How to Generate a Batch Net Requirements Report

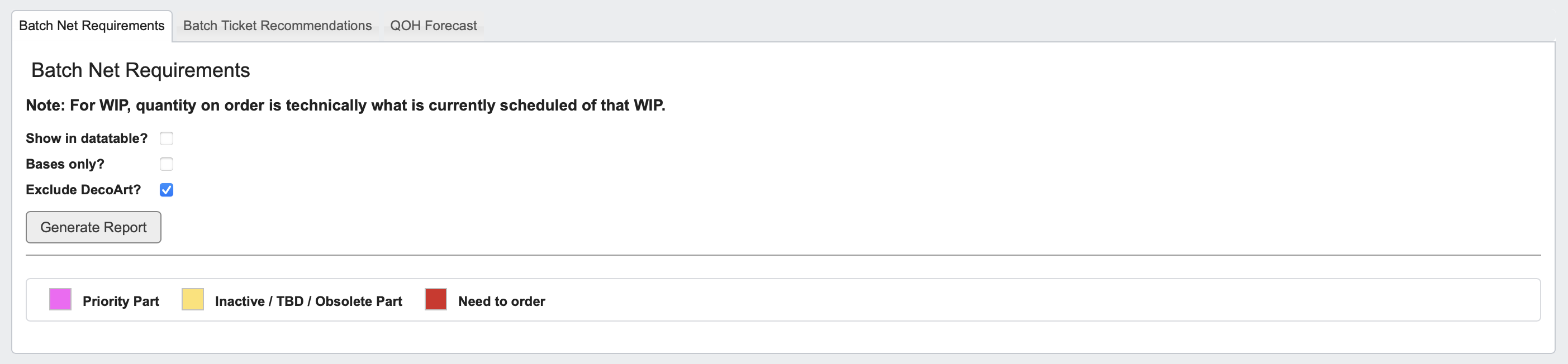

Screenshot 2025-11-04 at 4.48.55 PM.png Each vendor will have its own card on this screen, showing all parts associated with that vendor along with their setup details and requirements.
  1. Click the Batch Net Requirements tab.
  2. Choose your report options:
    • Show in datatable: Display data in table format.
    • Bases only: Limit to base materials.
    • Exclude [YOUR COMPANY]: Omit internal parts.
  3. Click Generate Report to view Part quantities scheduled and needed, Production Week information, Weekly Usage, and more.
Line items may be highlighted indicating the following:
  • Pink: Priority part.
  • Yellow: Inactive/obsolete part.
  • Red: Part needs to be ordered.

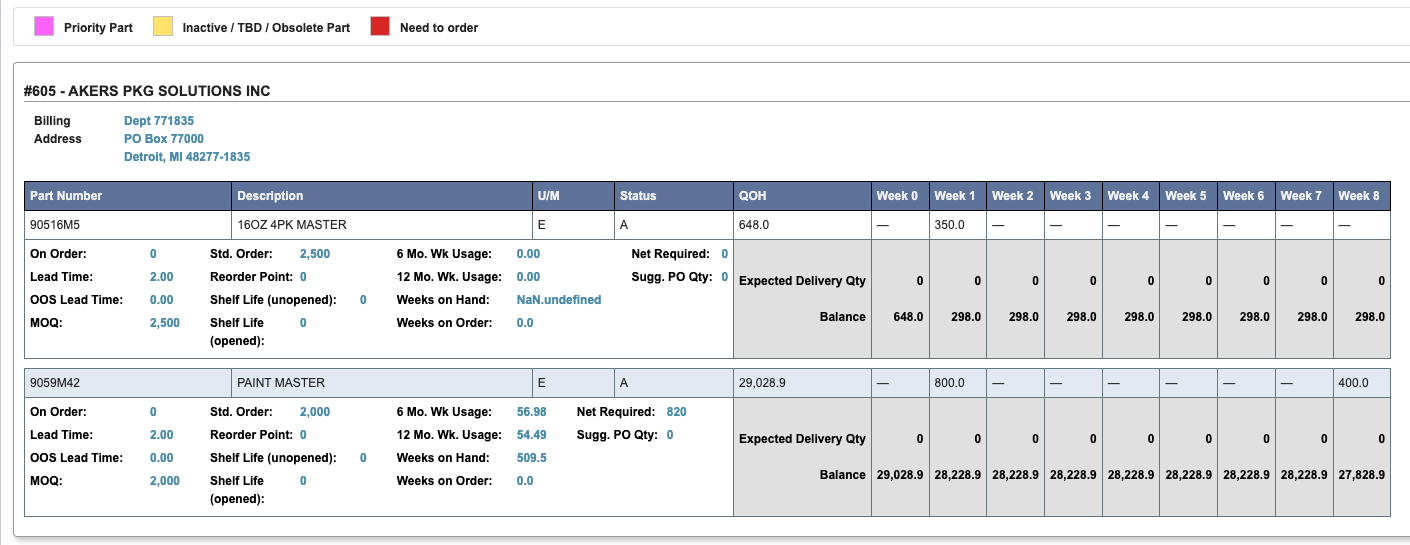

This report is useful for: planners and purchasing teams to identify materials that must be ordered or prioritized for production. image.png

How to Generate a Batch Ticket Recommendations Report

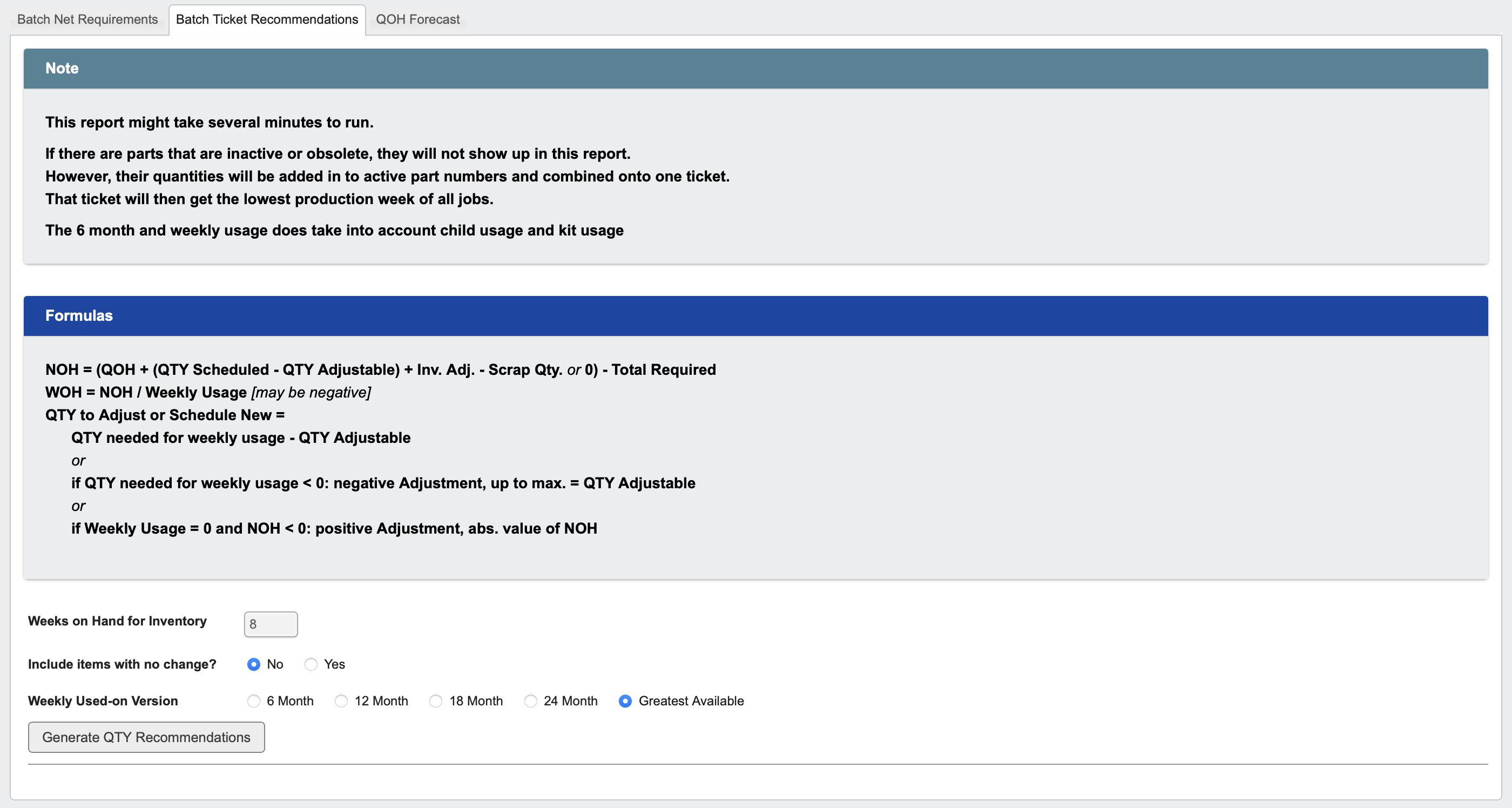

Screenshot 2025-11-04 at 4.32.54 PM.png
  1. Click the Batch Ticket Recommendations tab.
  2. Calculation formulas are provided for your reference, no action is required on them.
  3. Enter key parameters:
    • Weeks on Hand for Inventory: Target coverage (e.g., 8 weeks).
    • Include items with no change: Optionally include all items, even those without recommendation differences.
    • Weekly Used-on Version: Choose a usage range (6-, 12-, 18-, or 24-month; or Greatest Available).

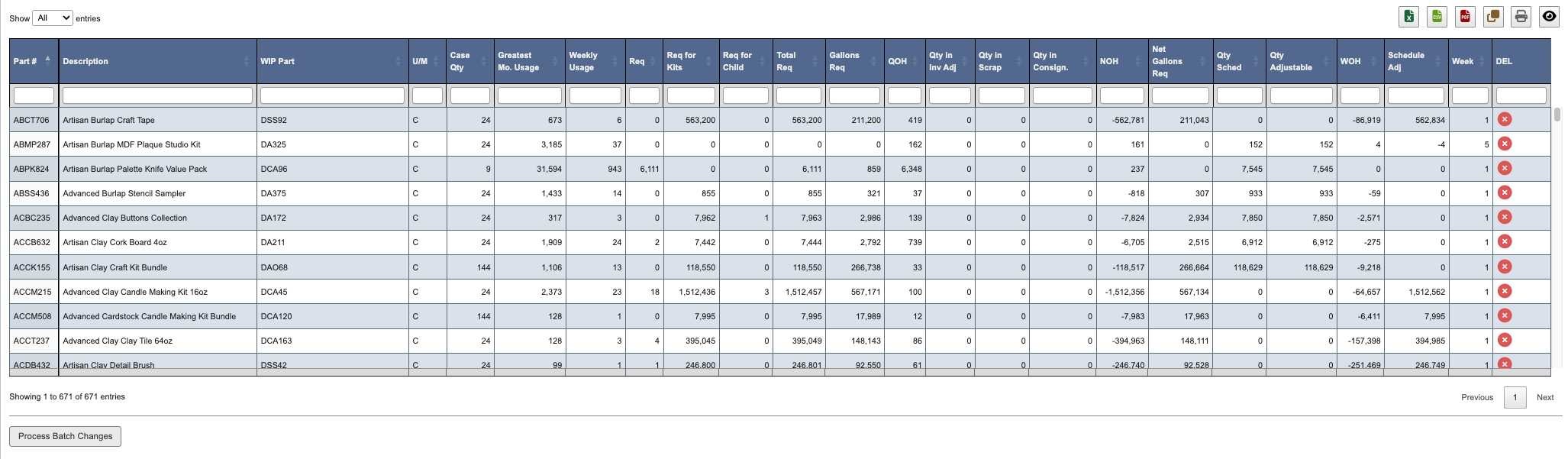

  4. Click Generate QTY Recommendations to produce the report. Screenshot 2025-11-13 at 10.57.05 AM.png
Adjustments can be made directly in the “Schedule Adj.” and “Weeks” columns if you want to modify the system-generated recommendations before processing. The generated report displays a detailed table of all reviewed parts and their calculated recommendations. Each row lists part-level metrics including usage, requirements, and scheduling adjustments. Click the X icon for a part to remove it from the report. Removed parts appear crossed out and can be restored by clicking the X icon again. When ready, click Process Batch Changes at the bottom of the screen. This will apply all recommendations, along with any adjustments made to generate new or updated batch tickets and bottling jobs. This report is useful for: Production schedulers to adjust batch planning and maintain optimal stock levels based on real usage patterns.

How to Generate a QOH (Quantity on Hand) Forecast Report

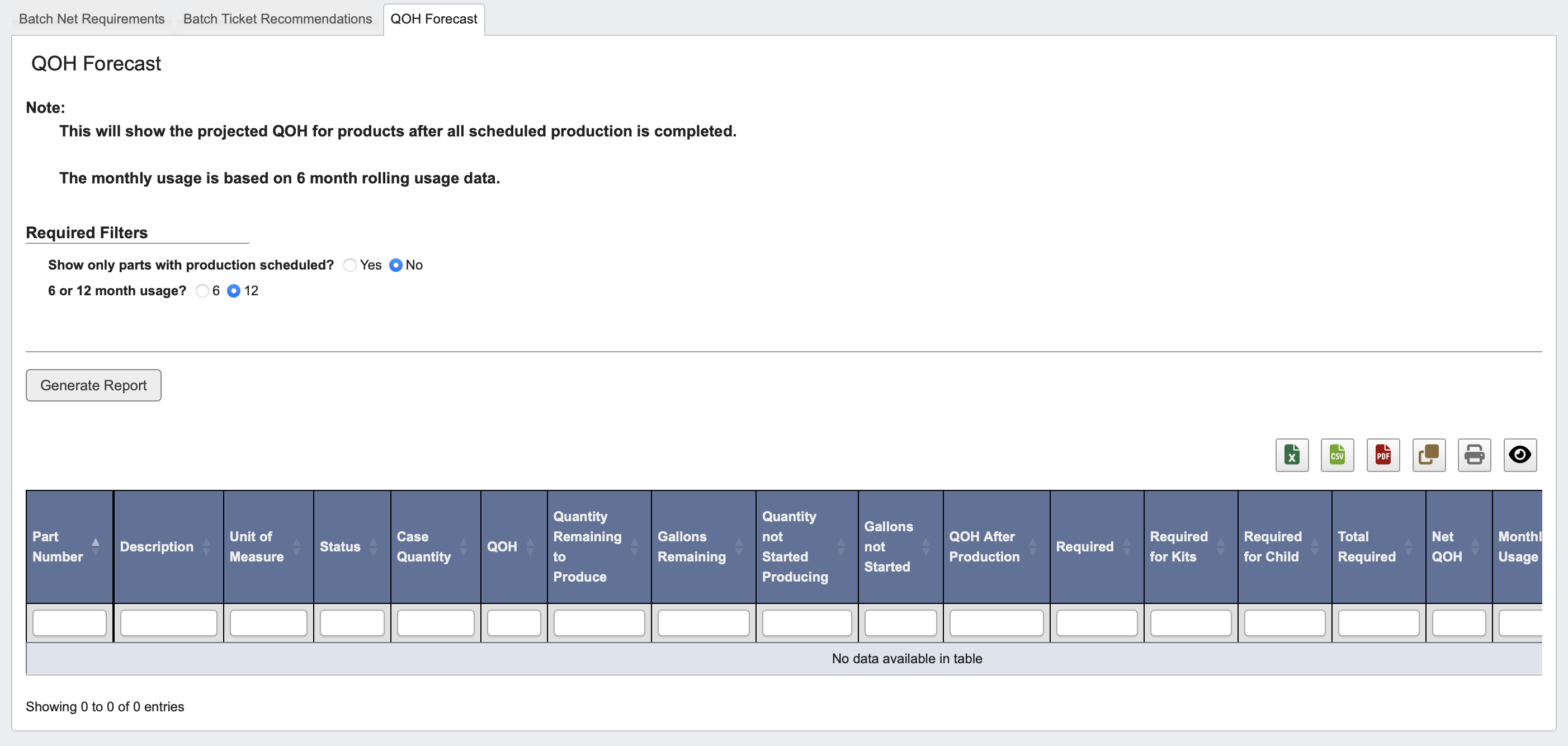

Screenshot 2025-11-04 at 4.32.38 PM.png
  1. Click the QOH Forecast tab.
  2. Choose filters:
    • Show only parts with production scheduled?: Yes or No.
    • 6 or 12 month usage?: Select usage window for forecasting.
  3. Click Generate Report to view projected post-production inventory levels.
This report is useful for: inventory analysts and production planners to forecast finished goods availability and align production timing with demand.
